Overview
Number of PPPs and Investment in PPPs
-
PPP Investment
N/A -
Number of PPPs Reaching FC
---- -
Value of PPPs Reaching FC
----
Revenue Model and Government Support to PPPs
-
Number of PPPs with Govt. Support
---- -
Number of User Charge PPPs
---- -
Number of Govt. Pay PPPs
----
PPPs under Preparation and Procurement
-
Number of PPPs under Preparation
---- -
Number of PPPs under Procurement
----
FC = financial closure, Govt. = government, M = million.
Source: Unicase Law, 2022.
In 2006, Kazakhstan adopted a new Concessions Law, which allowed the government to award several major concession projects, including the operation of the passenger terminal at the Aktau International Airport, construction and operation of the Yeraliyevo–Kuryk railway line, electrification of the Makat–Kandyagash railway line, construction and operation of the Kandyagash gas turbine power plant, and the the Big Almaty Ring Road (commonly known as BAKAD by its local abbreviation).
At the end of 2015, the government enacted the Law on Public–Private Partnership (the “PPP Law”) along with the necessary by-laws to support it. The new law did not replace the Concessions Law of 2006, which now intends to support “large-scale complex concessions,” but aims to function in parallel as a more flexible framework to implement small-scale and simpler projects at the regional level. From 2006, the legal term “concession agreement” could not be applied to any type of subsoil use contracts, whereas the PPP Law covers contracts involving subsoil use but only in conjunction with the provisions of the Subsoil Use Code. The government pushed for decentralized preparation, approval, and implementation of PPP projects, so that the regional and local authorities would have more power and could implement the regional-level PPP projects faster, without getting any approvals from the PPP Center or the line ministries.
The new amendments of the PPP Law and the Concessions Law passed in 2021 have introduced provisions that allow a concessionaire or a private partner to be selected based on the results of an auction. However, the necessary by-laws, including details and procedures for such auctions, have not yet been approved. Therefore, it is not yet clear how exactly the PPP and concession auctions will be conducted.1
- 1Unicase Law. 2021. PPP Law Version 2.1: Must-know Latest Amendments to the PPP Legislation. Almaty. https://unicaselaw.com/ppp-law-version-21-must-know-latest-amendments-ppp-legislation.
-
National Framework for Enabling PPPs
PPP Legal and Regulatory Framework
Does the country have - National PPP law and PPP regulations? Public financial management laws and regulations? Sector-specific laws and regulations? Procurement laws and regulations? Environmental laws and regulations? Laws and regulations for social compliance? Laws and regulations governing land acquisition and ownership? Taxation laws and regulations? Employment laws and regulations? Licensing requirements? What are the other components of the PPP legal and regulatory framework? Key legal acts clarifying the concession and PPP legislation are Order 157 dated 22 December 2014 (regulation of concessions), and Order 725 dated 25 November 2015 (regulation of PPP).- Yes
LEARN MORENational Framework for Enabling PPPs
PPP Legal and Regulatory Framework
Kazakhstan has two separate laws governing PPP:
- Law No. 167-III ZRK on Concessions, dated 7 July 2006 (the “Concessions Law”); and
- Law No. 379-V ZRK on Public–Private Partnership, dated 31 October 2015 (the “PPP Law”), along with the amendments thereto.
This duality has evolved from the initial absence in the PPP landscape of the build–transfer–operate (BTO) model, which has been first introduced in the Concessions Law and subsequently, with a wider range of available models, in the PPP Law (e.g., use of unsolicited proposals, equity participation via “institutional PPP,” three-party agreements). The current PPP landscape does not provide clear guidance on the choice between the two laws and specific instances or cases where one is preferred over the other.
The current legal framework and key acts that affect PPPs in Kazakhstan include the following:1
- Constitution of Kazakhstan
- Civil Code of Kazakhstan
- PPP Law
- Concessions Law
- Commercial Code of Kazakhstan
- Law of Kazakhstan on State Property
- Tax Code of Kazakhstan
- Land Code of Kazakhstan
- Budget Code of Kazakhstan
- Law of Kazakhstan on Securities Market
- Law of Kazakhstan on Project Finance and Securitization
- Law of Kazakhstan on Special Economic Zones
- Law of Kazakhstan on Natural Monopolies.
From a legal perspective, concession agreements are governed by the general provisions of the PPP Law (since they are also mentioned in the PPP Law) and in specific cases by the Concessions Law. The interaction between these two laws remains to be clarified, as this creates a legal ambiguity. In practice, the government perceives the Concessions Law as specific to only “complex concession projects.”2
There remain some strong legal uncertainties in both laws (e.g., regulation of the termination payments; accounting for, and treatment of, concession/PPP obligations from the state budget perspective). Two legal acts issued by the Ministry of National Economy attempt to address some of them:
- Order 157 dated 22 December 2014 (regulation of concessions), and
- Order 725 dated 25 November 2015 (regulation of PPPs and concessions, since the concessions are legally part of PPPs).
- 1Grata International. 2021. PPP in Kazakhstan. Almaty. http://www.gratanet.com/up_files/%5BGRATA%5D%20PPP%20in%20Kazakhstan.pdf.
- 2Large-scale, capital-intensive projects with long-term nature (similar to BAKAD).
Comparison of the Concessions Law and the PPP Law
Element Concessions Law PPP Law Full package of tender documentation should be approved and shared with the market (no limitations) before the request for qualifications (RFQs) stage. RFQ stage may be announced with the limited amount of information. Tender documentation may be prepared and approved between RFQ and request for proposals (RFPs) stages. Local feasibility study may be done by the government or prequalified bidders. Local feasibility study may be done by the government or the winning bidder. Only contractual PPP (no joint ventures with private investors). Concession agreement may have only two parties. More than one government agency/quasi-state agency can be a party to the PPP contract. Joint ventures with private partners are envisaged. Only the build–transfer–operate model is available. Several models of PPP are envisaged (according to Article 7 of the Law). Only “special importance” projects can benefit from international arbitration. International arbitration is applicable if one of the private partner shareholders (share is greater than 25%) is a foreign legal entity and the project itself is larger than a certain amount in terms of construction value.a Unsolicited proposals are not allowed. Use of unsolicited proposals is allowed. - Availability payments
- Land grants
- Government guarantees
- Availability payments
- Viability gap funding
- Equity contribution
- Land grants
- Government guaranteesa The total construction value should not be less than 4 million of monthly calculation index (MCI) (MCI is T3,180 as of September 2022). The total value should be about $27 million).
Source: Unicase Law LLP.
In this table the key differences between the Concessions Law and the PPP Law (including the two orders by MNE) from bankability perspective are summarized.
Small Public–Private Partnerships
The main goal for introducing small forms of PPPs was the implementation of PPP projects at the lowest level of governance (district level). Small PPPs have the following criteria:
- The PPP project does not belong to the sector of natural monopolies.
- The cost of the PPP project does not exceed $27 million, or about T13 billion (projects implemented at the local level).
- The selection of a private partner is carried out by using the standard tender documentation.5
- The PPP contract is signed in accordance with the standard draft.
Both laws require improvements in terms of bankability .
- 5See answers in the table under Section 6 of this chapter – “Public–Private Partnership Standard Operating Procedures, Toolkits, Templates, and Model Bid Documents.”
Outstanding Bankability Issues of PPP Legal and Regulatory Framework
Issue Status Quo International Best Practice Lenders direct agreement (LDA) The concept of “direct agreement” is available only for PPP/concession projects of “special importance” (see section on Projects of Special Importance). Allow LDAs for all PPPs and concessions. International arbitration International arbitration is available only to the “special importance” concession projects and to PPPs with foreign shareholders. Allow international arbitration for all PPPs and concessions. Calculation of termination payment The calculation of termination payments in both laws is linked to capital expenditure estimates, not to outstanding senior debt and equity. This creates ambiguities in numbers and requires legal drafting, in order to align with international practice. Swap breakage costs should be directly stipulated in the concession agreement. Link the termination payment to senior debt and equity. Budgeting of termination payments The budget legislation does not provide for a clear procedure for budgeting long-term obligations under PPP/concession agreements or a procedure for budgeting termination payments. Calling for termination payment is untested as of 2021. Provide a clear procedure for the budgeting of termination payments. PPP budget limits The PPP/concession budget limits set for regional akimats are restrictive (maximum of one to two large-scale projects). Link the concession/PPP limits to the net present value of annual payments under PPPs. Tender process The tender process for PPPs/concessions is not in line with international best practices (e.g., request for qualification and request for proposal documentations are not separated for concessions, requirement to submit technical pre-feasibility study, use of only financial criteria for prequalification). Clearly separate request for qualification stage from request for proposal stage. Allow to use technical and nontechnical qualification criteria. Acquisition of land plots Resettlement compensation is provided on market value basis. Provide resettlement compensation based on the replacement cost. Approval process for concessions The approval process of a project concept and tender documentation under the Concessions Law is too complicated and rigid (e.g., the need for a detailed local feasibility study in practice, and detailed capital expenditures and operational expenditures calculations should be based on local benchmarks). Provide more flexibility for the project with the tender procedures as only the market can indicate true costs of the project. Limited use of facility management model Due to the limitations of the Concessions Law and the PPP Law, the separation of operations (e.g., medical, education, water) from the facility management services are limited only to health-care projects. Allow facility management model for all infrastructure sectors. Source: Unicase Law LLP.
Projects of Special Importance
Schedule 4 of Order 725 stipulates that for a project to be recognized as one of “special importance,” it should meet the following criteria:
- High technical complexity of the project. The project should be attributed Category I of technical complexity, defined by the Law of the Republic of Kazakhstan dated 16 July 2001 “On architectural, urban planning and construction activities in the Republic of Kazakhstan.”
- It is socially important.3
- Its economic benefits are spread across several regions of Kazakhstan (excluding light rail transit [LRT] projects in Astana, Almaty, and Shymkent).4
- Its estimated total construction value is not less than 4 million of monthly calculation index (MCI) (MCI is T3,180 as of 2022, that is, a total value of about $27 million).
- Evaluation and selection applications are carried out by a special commission created by the Government of Kazakhstan in relation to republican concession projects and the local executive body in relation to local concession projects (see Concessions Law, Article 19, para. 4).
- Evaluation and selection of competitive applications of potential private partners is carried out by a special commission created by the organizer (see Order No. 725, Appendix 1, clause 75).
According to both the Concessions Law and the PPP Law, the Government of Kazakhstan approves the list of projects of special importance.
- 3A public authority promoting a concession project can categorize its project as “socially important” in its tender documentation, if the project relates to social welfare, public service and protection, healthcare, secondary schools, preschool or nursery education, municipal infrastructure, or transport spheres and will result in increasing the number of facilities in said spheres.
- 4LRT projects are not required to meet this criterion.
National Framework for Enabling PPPs
Types of PPPs
Service Contracts
Management Contracts
Affermage or Lease Contracts
Design-Bid-Build (DBB)
Design-Build (DB)
Build-Operate-Transfer (BOT)
Design-Build-Finance-Operate-Transfer (DBFOT)
Build-Own-Operate (BOO)
Concessions
Joint Venture
Hybrid Contracts
Others
- Build-Own-Operate-Transfer (BOOT)
- Life Cycle Contract
- Trust Management Of State-Owned Property
- Property Rental (lease) Of State Property
- Contracts For The Development Of Technology, Prototyping, Pilot Testing, And Small-Scale Production
- Design-build-finance-operate-maintain (DBFOM)
LEARN MORENational Framework for Enabling PPPs
Types of PPPs
The PPP Law also expanded the list of PPP arrangements. There are now two ways to formalize a PPP:
- institutional basis (with the creation of a special purpose vehicle as a joint venture), or
- contractual basis (with or without the creation of a special purpose vehicle).
The objectives of the projects proposed on institutional basis are
- to create an alternative to state entrepreneurship;
- for the public and private partners to form equity to attract funding, thereby increasing the ability to take up more projects; and
- to adopt a mechanism for the state’s exit from the project over time.1
In terms of models, the PPP legal landscape allows for the use of a wide range of structures, including
- build–transfer–operate (BTO);
- build–operate–transfer (BOT), build–own–operate–transfer (BOOT), or design–build–finance–operate–maintain (DBFOM); and
- build–own–operate (BOO).
As was mentioned above, the Concessions Law focuses on the BTO model only.
The use of facility management model is only applicable for health-care projects. As for the projects in all other sectors, the concessionaire/private partner would have to be responsible for the primary service provision along with the operations of the facility, according to the amendments to the Healthcare Code introduced specifically to allow it. Other industry-specific laws do not contain such caveats.
Payment mechanisms are also to be structured out of several separate payments, each designated to compensate for capital expenditures, operation and maintenance costs, and financing costs, among others. This requirement potentially creates gaps in understanding what is covered between the expectations of the sponsors and senior lenders from one side, and the government from the other side.
- 1Nurlan Shokbarbayev, Director, Investment Policy, Department of the Ministry of National Economy. 2021. Law as the Basis for the Development of PPP in Kazakhstan. Presentation at the PPP Forum. https://forum.kzppp.kz/en/ (in Russian).
National Framework for Enabling PPPs
Eligible Sectors for PPPs
Road Infrastructure
Roads, expressways, highways, bridges
Rail and Mass Transit Infrastructure
Metro rail, monorail, LRT, and trams
Waterways Infrastructure
Seaport Infrastructure
Airport Infrastructure
Passenger terminal, cargo terminal, other airport facilities
Logistics Infrastructure
Water Resources and Irrigation Infrastructure
Irrigation network, dams, weir, reservoirs, water storage infrastructure
Water Supply Infrastructure
Integrated water supply system, raw water transmission and treatment, water treatment plants, water treatment and distribution, bulk water supply
Wastewater Infrastructure
Sewerage/wastewater treatment plants, sewerage/wastewater treatment, and distribution of treated water
Solid Waste Management Infrastructure
Integrated solid waste management system, waste collection, segregation and transfer, waste treatment and disposal
Telecommunication Infrastructure
IT and Informatics Infrastructure
Power Generation
Renewables and non-renewables
Power Transmission and Sub-Transmission
Power Distribution
Energy Conservation Infrastructure
Education Infrastructure
Primary education, international schools, student dormitories
Health Infrastructure
Hospitals (primary, secondary, tertiary), diagnostic centers
Public Housing
Government Buildings
LEARN MORENational Framework for Enabling PPPs
Eligible Sectors for PPPs
PPP has been utilized in a wide range of infrastructure sectors and subsectors in Kazakhstan across the republican and regional levels and across various economic and social infrastructure sectors.
Both laws state that the PPP procurement method can be used for projects in any sector of the economy. Social infrastructure has been identified as a key priority, including education, health care, housing, and public utilities. Transport and power are also prioritized by these laws.
However, Government Resolution No. 710 dated 6 November 2017 “On list of objects which cannot be transferred for implementation of public–private projects, including concession,” defines some limits, where in certain types of property may not be PPP or concession assets, such as land, water, property of national bodies, military equipment, or backbone railway network.
According to the legal act, among other things,
- water sources and water supply facilities cannot be transferred into concession, unless they are inseparable from the land use rights related to, or for the purposes of realization of a concession project; and
- health organizations engaged in blood supply service and prevention of HIV/AIDS and organizations of emergency medicine cannot be transferred through PPP.
This legal act applies to both the PPP Law and the Concessions Law.
ICT = information and communication technology.
Source: Government Resolution No. 710 dated 6 November 2017.
National Framework for Enabling PPPs
PPP Institutional Framework
Does the country have a national PPP unit? What are the functions of the national PPP unit? Supporting the design and operationalization of the national PPP-enabling framework?
Helping develop a national PPP pipeline?
Supporting the arrangement of funding for project preparation (budgetary allocations, technical assistance funding from multilateral development agencies, operating a dedicated project preparation/project development fund)?
Turar Healthcare (healthcare PPPs); Financial Center (education PPPs) Guidance for project preparation to and coordination with the government agencies responsible for sponsoring the projects?
Turar Healthcare (healthcare PPPs); Financial Center (education PPPs) Making recommendations to the PPP Committee and/or other approving authorities to provide approvals associated with various stages of PPP process?
- Yes
- No
LEARN MORENational Framework for Enabling PPPs
PPP Institutional Framework
The Ministry of National Economy (MNE) is the authorized ministry for leading the PPPs in the country and is assisted by the PPP Center which plays the role of a PPP unit for the country. MNE plays an overarching monitoring role for the PPPs and is responsible for drafting PPP legislations and issuing guidelines. The other entities that play an important role in the development of the PPP policy in the country include the Ministry of Finance, line ministries, local authorities, Turar Healthcare (for health-care PPPs only), JSC Financial Center (for education PPPs only), and the Atameken National Chamber of Entrepreneurs.
Key Institutions Responsible for PPP
Institution Role in Promoting PPP Government of Kazakhstan Approves the list of “PPP projects of special importance” and the list of PPP facilities that require closed competitive bidding process. Approves the concession/PPP obligations for each republican project (via State Budget Commission). Ministry of National Economy (MNE) Responsible for the state policy and framework for implementation of PPP projects and coordination of the PPP activities within the country. Provides the regulations for setting limits of total concession/PPP obligations at the republican and local budget level. Approves (via PPP Center) tender documentation packages for the republican projects. Ministry of Finance Executes state guarantee agreements and state surety agreements on behalf of the state. Approves the tender documentation packages for the republican PPPs. Each central government authority (line ministry) Responsible for national PPP projects within its sectors of responsibility. The sector ministry prepares and approves tender documentation packages related to the national state property project, taking into account private initiative proposals, and organizes the tender. Akimats (regional governments) Responsible for regional PPP projects in their respective regions. It prepares proposals related to projects that are municipal property and acts as organizer of the tender process or of direct negotiations in the case of unsolicited proposals.
The list of PPP projects has to be approved by the local representative body (maslikhat). The local PPP centers under the akimats act as a center of expertise and approval body for local PPPs.Center for Public–Private Partnership (the "PPP Center") The PPP Center is a research and expertise center acting as an adviser on PPPs for the Government of Kazakhstan. The key role of the PPP Center is to approve tender documentation packages for the republican PPPs on behalf of MNE and provide PPP-related capacity-building training. Turar Healthcare and Financial Center JSC Turar Healthcare is the national operator of projects in the health-care sectors responsible for the promotion of PPP and investment projects in the sector. JSC Financial Center is the operator of PPP in the education sector. Both are mandated to engage in the development and implementation of PPP projects in their respective sectors and be parties to PPP agreements. National Chamber of Entrepreneurs “Atameken” The main functions of the National Chamber of Entrepreneurs include participation in the tender commission to determine a private partner and participation in monitoring the implementation of PPP projects. JSC = joint stock company.
Sources: ADB. 2019. Public–Private Partnership Monitor. Second Edition. Manila. https://www.adb.org/sites/default/files/publication/509426/ppp-monitor-second-edition.pdf; Unicase Law LLP.
Entities Responsible for PPP Project Identification, Approval, and Oversight
Parameter Who is responsible for identifying, preparing, and procuring the PPP projects? Identification and preparation – line ministries for republican projects; regional akimats for regional projects.
Approval – line ministry, MNE (via PPP Center) and MOF for republican projects; local akimats for regional projects.
Procurement – line ministries (Republic of Kazakhstan) on a republican level, local akimats on a regional level.
Is there a PPP committee for providing approvals at various stages of the PPP projects? Who are the approving authorities other than the PPP Committee for PPP Projects? Project identification – approval from the line ministry.
Feasibility study – Gosexpertiza (construction inspection and approval under MIID).
Tender documentation – line ministry, MNE (via PPP Center), MOF.
Tender evaluation – tender committee (representatives from the line ministry, MNE, MOF, Atameken, and other relevant government agencies and bodies on a case-by-case basis.)
State Budget Commission approves limits on concession/PPP commitments.
Variations during project implementation – line ministry, MNE, MOF, State Budget Commission.
State Budget Commission approves limits on concession/PPP commitments for both national and local budgets
Does the country have an independent think tank for various PPP planning, budgeting, and policy decisions? Is there a legislature for the PPP program oversight? - No
MIID = Ministry of Industry and Infrastructure Development, MNE = Ministry of National Economy, MOF = Ministry of Finance, NA = not applicable.

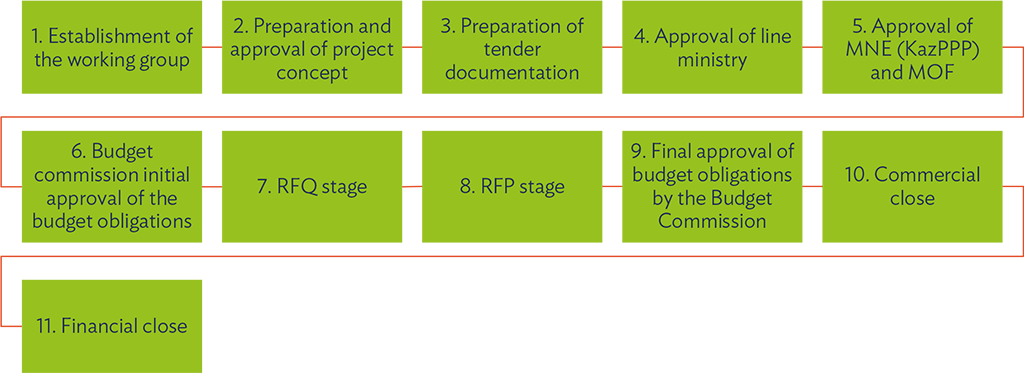

Concession and PPPs Preparation and Procurement Process
KazPPP = Kazakhstan PPP Center, MNE = Ministry of National Economy, MOF = Ministry of Finance, RFP = request for proposal, RFQ = request for qualification.
Source: Unicase Law LLP.
In the case of concessions, full tender documentation pack (including RFQ and RFP information, and concession agreement draft) should be prepared and approved before the tender launch. The tender documentation should be disclosed to prospective bidders without limitations. Detailed approved shadow-bid financial models should be part of the tender documentation, which is somewhat unusual from the market perspective.
As for the PPPs, in contrast, the two-stage tenders may be announced with the terms of reference only, without requiring complex approvals, and the tender documentation itself should be prepared and approved between RFQ and RFP stages.
In the absence of a value-for-money methodology, and with the emergence of unsolicited proposals, for some projects, stages 1 and 2 are often skipped, and the line ministries and akimats proceed straight to preparing the tender documentation.
Entities Responsible for PPP Project Monitoring
Parameter Monitoring of PPP projects post commercial close? MOF and line ministries via the PPP Center for republican projects
Akimats for regional projectsSupporting the monitoring and management of fiscal risks and liabilities from PPP projects for the MOF? MNE and line ministries via the PPP Center for republican projects
Akimats for regional projectsMNE = Ministry of National Economy, MOF = Ministry of Finance.
The process of monitoring project performance for concessions (regulated by Order 157) and PPPs (regulated by Order 725) is under both the line ministries (e.g., MOH for health-care projects, and the MNE via the PPP Center). For regional projects, project monitoring is under the responsibility of the akimats. The PPP Center has no monitoring role for regional projects.
The day-to-day contract management is usually done by the relevant line ministry or the akimat (the contracting authority).
National Framework for Enabling PPPs
The PPP Process
Does the PPP legal and regulatory framework provide for a PPP implementation process covering the entire PPP life cycle? Does the Feasibility Assessment Stage cover Technical feasibility?
Socioeconomic feasibility?
Environmental sustainability?
Financial feasibility?
Fiscal affordability assessment?
Legal assessment?
Risk assessment and PPP project structuring?
Value for Money assessment?
a Market sounding with stakeholders?
a Is the PPP procurement plan required? Is there a need to set up a separate PPP procurement committee? b Is competitive bidding the only method for selection of PPP private developer? Is the prequalification stage necessary? Or does the PPP legal and regulatory framework allow flexibility to skip the prequalification stage? Does the PPP legal and regulatory process provide the option to the preferred bidder for contract negotiations? Does the PPP legal and regulatory framework allow unsuccessful bidders to challenge the award/submit complaints? What is the maximum time allowed for submitting a complaint/challenging the award by unsuccessful bidders from the announcement of the preferred bidder? Does the PPP legal and regulatory framework provide for transparency? (for open tenders) Which of the following are required to be published? Findings from the feasibility assessment?
Procurement notice?
Outcome of stakeholder consultations from market sounding?
Clarifications to prequalification queries?
Prequalification results?
Clarifications to pre-bid queries?
Results for the bid stage and selection of preferred bidder?
Final concession agreement to be entered between the government agency and the preferred bidder? And other PPP project agreements executed between government agency and preferred bidder?
Confidentiality
- aWorld Bank Group. 2020. Benchmarking Infrastructure Development 2020 in Kazakhstan. https://bpp.worldbank.org/economy/KAZ.
- bPoints 74 and 75 of Order 725 define tender commission setting procedures, composition, representatives, and functions in the tender process.
- Yes
- No
- Unavailable
LEARN MORENational Framework for Enabling PPPs
The PPP Process
The Concessions Law provides the opportunity to select concessionaire via a competitive process only:
- in an open tender (one-stage, two-stage); and
- via an auction (not specified in the legal acts and not used in practice as it was introduced recently).

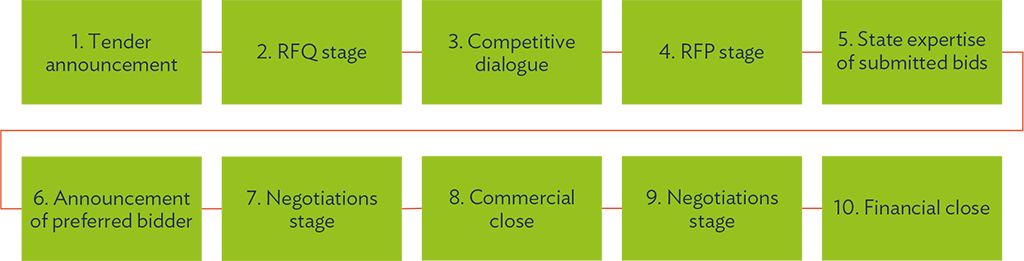

Tender Process (Concessions Law)
RFP = request for proposal, RFQ = request for qualification.
Source: Unicase Law LLP.
For the single-stage tenders, only RFP stage is used without RFQ.
Unlike the Concessions Law, the PPP Law provides for the possibility to select a private partner through various processes:
- Open tender (one-stage, two-stage, simplified – for local project only)
- Auction (not specified in the legal acts and not used in practice)
- Direct negotiations (for unsolicited proposals).
The simplified tender procedure can be held only for the regional projects whose construction costs do not exceed 4 million times the monthly calculated index,1 using standard tender documentation and standard contract,2 and the project is not subject to natural monopoly regulation.

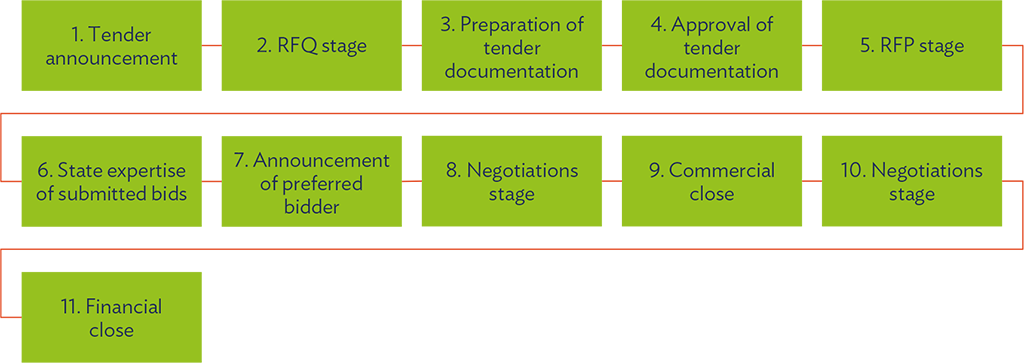

Tender Process (Public–Private Partnerships Law)
RFP = request for proposal, RFQ = request for qualification.
Source: Unicase Law LLP.
Single-stage tenders only require an RFP, without the RFQ. No state approval is required in the simplified procedure.
Sources: ADB. 2019. Public–Private Partnership Monitor. Second Edition. Manila.https://www.adb.org/sites/default/files/publication/509426/ppp-monitor-second-edition.pdf Unicase Law LLP
National Framework for Enabling PPPs
Standard Operating Procedures, Tool Kits, Templates, and Model Bid Documents for PPPs
Does the country have PPP Guidelines/PPP Guidance Manual? Does the PPP Guidelines/PPP Guidance Manual adequately cover the process, entities involved, roles and responsibilities of various entities, approvals required at various stages, and the timelines for the various stages of the PPP project life cycle? What are the templates and checklists available in the PPP Guidelines/PPP Guidance Manual? Project Needs Assessment and Options Analysis checklist?
Project Due Diligence checklist?
Technical Assessment checklist?
Environmental Assessment checklist?
PPP Procurement Plan template?
Does the country have standardizedmodel bidding documents for PPPs? Model Request for Qualification (RFQ) document?
Model Request for Proposal (RFP) document?
Model PPP/Concession Agreement?
State Support Agreement?
VGF Agreement?
Guarantee Agreement?
Power Purchase Agreement?
Capacity Take-or-Pay Contract?
Fuel Supply Agreement?
Transmission and Use of System Agreement?
Performance-Based Operations and Maintenance Contract?
Engineering, Procurement and Construction Contract?
Does the country have standardized PPP agreement terms? Does the country have standardized/ model tool kits to facilitate identification, preparation, procurement, and management of PPP projects? PPP Family Indicator?
PPP Mode Validity Indicator?
PPP Suitability Filter?
PPP Screening Tool?
Financial Viability Indicator Model?
Economic Viability Indicator Model?
VFM Indicator Tool?
Readiness Filter?
Is there a framework for monitoring fiscal risks from PPPs including the following? Process for assessing fiscal commitments?
Process for approving fiscal commitments?
Process for monitoring fiscal commitments?
Process for reporting fiscal commitments?
Process for budgeting fiscal commitments?
Are there fiscal prudence norms/thresholds to limit fiscal exposure to PPPs? Is there a process for assessing and budgeting contingent liabilities from PPPs? - Yes
- No
LEARN MORENational Framework for Enabling PPPs
Standard Operating Procedures, Tool Kits, Templates, and Model Bid Documents for PPPs
Order No. 277 dated 27 March 2015 provides the concession agreement template, while Order No. 724 dated 25 November 2015 approves the PPP agreement template as well as the standard tender documentation pack for PPP projects.
The PPP Center has also prepared a White Book which summarizes the required procedures for concession and PPP projects.1
- 1Yvision.kz. 2016. White Book: Practical Recommendations for Implementing PPP. Almaty. https://yvision.kz/post/690174 (in Russian).
VFM = value for money, VGF = viability gap fund.
Key Clauses Related to PPP Agreements
Does the law specifically enable lenders the following rights: Security over the project assets?
for Concessions Law Security over the land on which they are built (land use right)?
Security over the shares of a PPP project company?
Can there be a direct agreement between the government and lenders?
(For special importance projects only) Do lenders get priority in the case of insolvency?
Can lenders be given step-in rights?
(For special importance projects only)a Does the law specifically enable compensation payment to the private partner in case of early termination due to: Public sector default or termination for reasons of public interest?
Private sector default?
Force majeure?
Does the law enable the concept of economic/financial equilibrium? Does the law enable compensation payment to the private partner due to: Material adverse government action?
Force majeure?
Change in law?
- aThe regulations provide for substitution rights, and does not explicitly indicate the step-in rights, by the lenders in consultation with the granting authority.
- Yes
- No
LEARN MORENational Framework for Enabling PPPs
Standard Operating Procedures, Tool Kits, Templates, and Model Bid Documents for PPPs
Key Clauses Related to PPP Agreements
Both the Concessions Law (Article 21) and the PPP Law (Article 46) prescribe the key elements of agreements between the public and parties in Kazakhstan.
Differences between the Concessions Law and the PPP Law
Element Concessions Law PPP Law Only two parties can be sides to the agreement. Both public and private sides can have multiple parties to the agreement, including financing organizations. Only contractual public–private partnership (PPP) (no joint ventures with private investors).
Concession agreement may have only two parties.
More than one government agency/quasistate agency can be a party to the PPP contract. Joint ventures with private partners are envisaged. Only the build–transfer–operate model is available. Several models of PPP are envisaged, according to Article 7 of the Law. - Availability payments
- Land grants
- Government guarantees
- Availability payments
- Viability gap funding
- Equity contribution
- Land grants
- Government guaranteesOnly “special importance” projects can benefit from international arbitration. International arbitration is applicable if one of the private partner shareholders (share is greater than 25%) is a foreign legal entity and the project itself is larger than certain amount in terms of construction value.a Only “special importance” projects can benefit from indexation of payments to foreign exchange. The PPP Law allows the inclusion of clauses to mitigate foreign exchange risks regardless of the project’s status. a Total construction value should not be less than 4 million of monthly calculated index (MCI is T3,180 as of September 2022, total value should be about $27 million).
Source: Unicase Law LLP.
In this table the key differences between the Concessions Law and the PPP Law from a bankability perspective are summarized.
Other Critical Contractual Provisions and PPP-Enabling Considerations
The Civil Code of Kazakhstan provides for the following types of security interests: penalty, pledge, retention of the debtor’s property, suretyship, guarantee, deposit, and guarantee deposit. Pledges and guarantees are the most used forms of security in Kazakhstan.
Though the assignment is not strictly indicating a type of security under Kazakhtan’s law, it is quite often a part of a standard security package in international finance transactions. It should be noted that both the Concessions Law and the PPP Law stipulate the right of concessionaire/private partner to transfer its rights to third parties with the consent from the grantor (security clauses are not stipulated directly).
Furthermore, in a typical project finance deal, creditors require “step-in” rights that enable them to appoint a nominee to undertake the project company rights together with the project company itself (with the project company remaining liable for all the obligations) or appoint a new obligor in place of the project company to repay the amounts due to the lenders. These “step-in” rights enable the lenders to take over control of the project. The concept of “step-in” rights is recognized in the Concessions Law and the PPP Law for projects with “special importance” status only.
The regulatory framework expressly regulates the modification allowed or renegotiation of a concession/PPP agreement, in particular:
- when there is a change in the investment plan or contract duration,
- in case of a force majeure event, and
- when there is a material adverse action from the government.
According to the Concessions Law and the PPP Law, the public partner can terminate the concession/PPP agreement:
- in case of material breach of the agreement by the private partner;
- if the private partner is in bankruptcy; and
- in the interest of society and the state (effectively an expropriation opportunity).
For projects under the PPP Law, a court order may be required.
The private partner can only terminate the agreement by the court’s order, but only in case of material breach of the agreement by the public partner.
The termination compensation formula is rather unusual. Instead of the widely accepted “senior debt plus some equity” approach, Order 725 stipulates (both for PPPs and concessions) that the state would only compensate for “incurred and verifiable capital costs associated with the construction/reconstruction of the PPP facility minus the payments already provided by the public partner.” Calculation of capital costs is usually based on local feasibility study,1 which in turn, may be based on outdated local cost norms and estimates. This creates ambiguity and additional complexity from the lenders’ point of view.
- 1A local feasibility study is the document prepared in accordance with the legislation of the Republic of Kazakhstan. The calculations should be based on the local norms and benchmarks which are outdated. The local feasibility study is approved by the government (Gosexpertiza, a construction permitting agency under MIID).
Sources: ADB. 2019. Public–Private Partnership Monitor. Second Edition. Manila.https://www.adb.org/sites/default/files/publication/509426/ppp-monitor-second-edition.pdf Unicase Law LLP.
National Framework for Enabling PPPs
Unsolicited PPP Proposals
Does the PPP legal and regulatory framework allow submission and acceptance of unsolicited proposals? What are the advantages provided to the project proponent for an unsolicited bid? Competitive advantage at bid evaluation?
Swiss Challenge?
Compensation of the project development costs?
Government support for land acquisition and resettlement cost?
Government support in the form of viabiity gap funding and guarantees?
- Yes
- No
LEARN MORENational Framework for Enabling PPPs
Unsolicited PPP Proposals
Article 44 of the PPP law stipulates a possibility for unsolicited proposals (“direct negotiations”) if the PPP project is initiated by a private partner that possesses the land plot/PPP facility (ownership or long-term lease) or the private partner has the intellectual property rights which are linked inextricably to the PPP facility.
Regarding the intellectual property rights, this clause was intended to be used for ICT projects. However, the vague wording of Article 44 has invited broader application of unsolicited proposal practices as well as attempts to use it in social infrastructure sector. The procurement authority may initiate a competitive PPP procurement procedure if there are several unsolicited proposals for the same PPP project.
It is, however, noted that provisions regulating the evaluation of unsolicited proposals do not address the need to ensure that the project is consistent with government priorities.
The conduct of accepting unsolicited proposals follows a step-by-step process:
- initiation of a PPP project by a potential private partner;
- general notification of the market of the initiation of a PPP project indicating the key technical and economic parameters of the PPP project and requested payments from the budget and/or measures of state support (If no alternative proposals have been received, parties move to the approval of a business plan);
- approval of a business plan (developed by the potential private partner) for a PPP project (similar to the feasibility study);
- negotiations between potential parties to a PPP agreement on the terms of the PPP agreement; and
- conclusion of a PPP agreement.
Unsolicited proposals are not allowed under the Concessions Law.
Sources: ADB. 2019. Public–Private Partnership Monitor. Second Edition. Manila. https://www.adb.org/sites/default/files/publication/509426/ppp-monitor-second-edition.pdf Unicase Law LLP.
National Framework for Enabling PPPs
Foreign Investor Participation Restrictions
- aForeign ownership on land is allowed except for agricultural lands, where foreigners and legal entities with foreign ownership of 50% and more cannot own land.
- bThere are no currency conversion restrictions. Foreign exchange comfort may be provided via payment mechanism in concession/PPP agreements.
- Yes
- No
Sources: World Bank. Infrastructure Finance, PPPs and Guarantees. Country Snapshots. Kazakhstan. (accessed 18 October 2022); Unicase Law LLP.
National Framework for Enabling PPPs
Dispute Resolution
Does the country have a Dispute Resolution Tribunal? Does the country have an Institutional Arbitration Mechanism? Can a foreign law be chosen to govern PPP contracts? Only for PPPs when the private partner (a special purpose vehicle) is a foreign entity What dispute resolution mechanisms are available for PPP agreements? Court litigation
Local arbitration
International arbitration
Concessions - for the special importance projects only and if one of the shareholders of the concessionaire is a foreign entity; PPP only if one of the shareholders of the private partner is a foreign entity (share is more than 25%) and the size of the project is more than 4 million times the monthly calculated indexa Has the country signed the New York Convention on the Recognition and Enforcement of Foreign Arbitral Awards? - aMCI is T3,180 as of September 2022, that is, the total value should be about $27 million.
- Yes
LEARN MORENational Framework for Enabling PPPs
Dispute Resolution
The PPP law explicitly confirms that if a private sector partner under a PPP agreement is a nonresident, the parties shall have the discretion to choose the applicable law of the PPP agreement.
When the dispute cannot be resolved, the parties to the PPP contract have the right to settle the dispute in accordance with the requirements of the Republic of Kazakhstan legislation in the courts or in arbitration (with limitations, table in section 9).
Schedule 8 of Order 157 stipulates the special importance criteria for the concession projects which are identical to the criteria in Order 725 with one exception—Order 157 does not introduce a special regime for LRT projects.
Source: Unicase Law LLP.
National Framework for Enabling PPPs
Environmental and Social Issues
Is there a local regulation establishing a process for environmental impact assessment? Is there a legal mechanism for the private partner to limit environmental liability for what is outside of its control or caused by third parties? Is there a local regulation establishing a process for social impact assessment? Is there involuntary land clearance for PPP projects? - Yes
- No
LEARN MORENational Framework for Enabling PPPs
Environmental and Social Issues
In Kazakhstan, the environmental legislation falls under the Environmental Code.1 The environmental impact assessment (EIA) is mandatory for facilities that can have an impact on the environment or human health. The code is based on the experience of OECD countries. The code provides a detailed procedure for conducting an environmental impact assessment. The code defines the nature and detail of the environmental permits required based on the industry’s category.
Chapter 7 of the Environmental Code provides a section on EIA, cases for which they have to be done, and the procedure for conducting the EIA.
Since all major PPPs in the country are usually supported by international financial institutions, the Equator principles and the environmental, social, and governance (ESG) safeguards are of critical importance for bankability. The key concern for such bankability in the local regulation is the resettlement compensation for which the market value for expropriated property should be applied instead of the “replacement cost.” The issue is normally resolved through the preparation of Land Acquisition and Resettlement Frameworks (or similar documents) which stipulate who will be responsible for the differences between the local regulations and the requirements of the Equator principles.2
Sources: World Bank Group. 2020. Benchmarking Infrastructure Development 2020 in Kazakhstan.https://bpp.worldbank.org/economy/KAZ Unicase Law LLP.
National Framework for Enabling PPPs
Land Rights
Which of the following is permitted to the private partner: Transfer land lease/use/ownership rights to third party
Use leased/owned land as collateral
Mortgage leased/owned land
Is there a legal mechanism for granting wayleave rights, for example, laying water pipes or fiber cables over land occupied by persons other than the government or the private partner? Is there a land registry/cadastre with public information on land plots? Which of the following information on land plots is available to the private partner? Appraisal of land value
Landowners
Land boundaries
Utility connections
Immovable property on land
Plots classification
- Yes
- No
LEARN MORENational Framework for Enabling PPPs
Land Rights
The provision of land plots for concession and PPP projects is directly stipulated in the Land Code of Kazakhstan.1 There are direct links in the Concessions Law and the PPP Law to the land legislation. The details on the provision of land plots are also provided in Order 157 (for concessions) and Order 725 (for PPPs).
Under current PPP practice, the land plots are usually allocated by the government or local akimats before the start of the approval procedures, and to be provided after the tender to the winning bidder. As a result, most risks related to the land (e.g., access roads and utilities) are borne and mitigated by the government.
- 1Land Code, Article 36, Point 1.
Sources: ADB. 2019. Public–Private Partnership Monitor. Second Edition. Manila.https://www.adb.org/sites/default/files/publication/509426/ppp-monitor-second-edition.pdf Unicase Law LLP.
Government Support for PPP Projects
Project Funding Support
Project Funding Support Is there a dedicated government financial support mechanism for PPP projects? What are the instruments of government financial support available under this government financial support mechanism? Capital grant
Operations grant
Annuity/availability payments
Guarantees to cover
Currency inconvertibility and transfer risk
Foreign exchange risk
War and civil disturbance risk
Breach of contract risk
Regulatory risk
Expropriation risk
Government payment obligation risk
Credit risk
Minimum demand/revenue risk
Risk of making annuity/availability payments in a timely manner
What are the caps/ceilings for the government financial support under each of the abovementioned government financial support instruments? Total investment in the projectIs there a minimum PPP project size (investment) for a PPP project to be eligible for receiving government financial support? Are there minimum financial commitment requirements for the private developer equity before the government support could be drawn? Is the government financial support required, usually the bid parameter for PPP projects? Are unsolicited PPP proposals eligible to receive government financial support? Are there standard operating procedures for providing government financial support to PPP projects? Appraisal and approval process
Budgeting process
Disbursement process
Monitoring process
Accounting, auditing, and reporting process
Who are the signatories to the government financial support agreement? Public partner and private partner as a general rule. The Ministry of Finance signs state guarantee and surety agreements.Who is responsible for monitoring the performance of PPP projects availing government financial support? Independent engineer?
Government agency?
Line ministry or relevant akimat Ministry of Finance?
Ministry of National Economy What are the other forms of government support available for PPP projects? Land acquisition funding support?
Funding support for resettlement and rehabilitation of affected parties?
Tax holidays/exemptions?
Real estate development rights?
Advertising and marketing rights?
Interest rate/cost of debt subventions?
Other subsidies and subventions?
Can the other forms of government support be availed over and above the government financial support through various instruments listed above? - Yes
- No
- Unavailable
LEARN MOREGovernment Support for PPP Projects
The legislation, in general, and the Budget Code, in particular, allow for three types of state support to PPP projects: (i) funding support, in the form of cofinancing; (ii) revenue support, mainly availability-type payments post completion and during operation; and (iii) credit enhancement instruments in the form of sureties and guarantees. However, the level of support, guarantees, and rights provided to concessionaires and private partners varies depending on the level of the project (republican versus regional) and its specifics (e.g., social importance, special significance).
The amounts of state support committed by the state for PPP/concession projects are bound by the limits of acceptance of PPP/concession obligations which are set each year for 3 years within the standard budget process. The limits (accrued and new) are calculated in accordance with formula adopted by the Ministry of National Economy (MNE) in its Order No.731 (last amended in December 2020).1 The PPP/concession limits depend on the annual revenues of each subnational budget, and the level of its obligations and liabilities to creditors, including banks and bonds. In most cases, they are prohibitively low to accommodate for large-scale, long-term regional projects.
In April 2021, the MNE amended its Order No. 129 of 5 December 2014 to add a new compulsory prerequisite (criterion) for the implementation of PPP projects (including concession projects). The amendment provides that the state obligations under the PPP projects, including state concession obligations (if necessary), should not exceed the amount of money spent or involved by the private partner (concessionaire) in the PPP (concession) project, including the private partner’s own funds. At the same time, the private partner shall involve its own funds into the project in the amount not less than 10% (for concession) and 20% (for PPP) of the value of the object. The effectiveness of this change was suspended until 1 April 2022; this suspension has now expired.2 This revision can potentially disrupt all future PPP projects as the state will not be able to provide availability payments and structure availability payment-based PPPs.
Funding Support
Cofinancing from state budget is currently the only method of providing viability gap funding for PPP projects that can be committed directly from the republican and/or regional budgets at the implementation stage, as reflected in Article 27, point 5 of the PPP Law and Concessions Law (Article 14, para. 1, sub-para 5). A more detailed mechanism for assuming and implementing the commitments on cofinancing is prescribed in Article 11 of the Budget Rules.3 It is unclear if they also apply to the projects structured in accordance with the Concessions Law. The implementing entities (i.e., line ministries or akimats) can cofinance the capital expenditures of the PPP projects within the budget limits of their respective budgets and programs, as calculated in accordance with the PPP Limits Methodology (footnote 1).
Equity contributions have become available with the adoption of the PPP Law and its concept of “institutional PPPs” (Chapter 6 of the PPP Law). It envisages the participation of the state-owned enterprises and quasi-state companies as an alternative to the cumbersome budget process of receiving state support as part of the contractual PPP. Approved according to the participating companies’ internal procedures, such involvement enhances the creditworthiness of the special purpose vehicle and may positively impact the financing cost.
Provision of land grants is administered in accordance with the relevant clauses of the Land Code (for instance, gratuitous provision of plot for use).4 The law allows for the risk allocation on the land plot-related risks, such as access roads, communications, and resettlement, to be borne by the public party. Land expropriation and resettlement risks should be carefully assessed and managed as the provisions of the Land Code may be insufficient to ensure compliance with ESG and Equator principles. In terms of expropriation and resettlement, a decree needs to be published by the government or the relevant akimat on the planned alienation of land, indicating the purpose, location, owner, and date of the property.
Revenue Support
The bulk of the PPP-specific state support measures relate to the project’s post-construction operations stage. The government provides revenue support through the following:
Investment cost compensation (ICC) is payable at the commencement of the project’s operation stage in accordance with the agreed payment schedule.5 It is limited to the following justifiable costs:6
- preparation of design documentation, cost estimates, surveys, assessments, evaluation of project feasibility, and obtaining licenses and receiving permits prior to project implementation required by Kazakhtan’s legislation;
- raw materials and materials, works, and services used in the creation (construction) of the object;
- project implementation and management expenses during the construction and implementation period, including technical and administrative expenses;
- accrued interest on short- and long-term debt (at market interest rates) and other debt service related expenses;
- all types of insurance costs required during the creation and/or reconstruction of the PPP object;
- depreciation accrued on the fixed and intangible assets used directly in the creation (construction) of the object; and
- other project-implementation-related expenses.
Operational cost compensation (OCC) is paid out of the state budget (republican or regional) aimed at reimbursing the expenses of the private partner related to the operation of the PPP object in accordance with a PPP agreement.7 OCC can be used to compensate the following operational costs:8
- costs related to the operation and maintenance of engineering and technological equipment;
- maintenance costs of buildings (structures) and territories;
- administrative costs (e.g., remuneration of administrative and managerial personnel, insurance costs, banking fees, communication and security services);
- tax expenses;
- insurance costs;
- debt service;
- other operating costs, which may include routine repairs, average repairs, and material costs (e.g., raw materials necessary for the operation of the PPP object, fuel, spare parts); and
- costs of keeping stocks, inventory, and reserves necessary for the operation of the PPP object (e.g., work clothes, food).
Management fee has been specifically introduced to reimburse for cases where the private partner is mandated with the responsibility of operating a state-owned asset (for concession projects, management fee description also includes the rent payable from the state budget to the concessionaire). Management fee effectively includes return on equity, foreign-exchange-related payments, debt service not covered by ICC, and other project-related costs.
- 1Order of the Minister of National Economy of the Republic of Kazakhstan dated 26 November 2015 No. 731 “On the Methodology of Determining the Limits of State Obligations on Concession/PPP Projects of the Government of the Republic of Kazakhstan and Local Executive Authorities” (the PPP Limits Methodology).
- 2Unicase Law Firm. 2021. Kazakhstan – PPP Criteria “1 To 1” Postponed for a Year. Almaty. https://www.conventuslaw.com/report/kazakhstan-pppcriteria- 1-to-1-postponed-for-a/.
- 3Order of the Minister of Finance of the Republic of Kazakhstan dated 4 December 2014 No. 540 “On approval of the rules of budget execution and its cash service” (the Budget Rules).
- 4Article 27 of the PPP Law; Article 6 of the Concessions Law.
- 5Order of the Minister of Finance of the Republic of Kazakhstan dated 4 December 2014 No. 540 “On approval of the rules of budget execution and its cash service” (the Budget Rules), para. 546.
- 6Rules No. 725, Appendix No. 7, para. 8.
- 7The Budget Rules, para. 564-1.
- 8Rules No. 725, Appendix No. 7, para. 23.
BAKAD Payment Structure
The Big Almaty Ring Road PPP, commonly referred to as “BAKAD” for its Russian abbreviation, had its payment mechanism structured in accordance with the provisions of the Concessions Law and Order 157. It consists of the following:
Fixed part (A)
- ICC, based on the investment costs of the local feasibility study (commonly referred to as “TEO”), not on the estimates of the winning bidder
- OCC, also based on the estimates of the TEO (also based on local feasibility study)
- Management fee, consisting of
- cost of equity,
- compensation for expenses during service period,
- additional expenses for construction (construction costs of the winning bid minus the construction costs according to the TEO), and
- additional expenses for operation (operating costs of the winning bid minus the operating costs according to the TEO).
Variable, or contingent, part (B)
- The foreign exchange compensation (legally part of the management fee).
- Adjustments for deductions.
The foreign exchange compensation part should be calculated in accordance with the following formula:
FXo - initial exchange rate
FXn - exchange rate at the moment of payment of availability payment in period nB - fixed component of availability payment in period n
The toll payments are collected by the government and are not part of the concessionaire’s revenue structure.
The BAKAD experience has demonstrated to the investor community the willingness of the public entity to accommodate the requirement for a robust payment that includes essential contingent obligations, such as the foreign exchange adjustment component.
The project is expected to generate tax revenue for the Government of Kazakhstan, and contribute to the national budget. Tax revenues will be generated through income taxes and corporate taxes on expenditures, operational and corporate revenues, and incomes of employees.
ICC = investment cost compensation, OCC = operation cost compensation, TEO = local feasibility study.
Source: Unicase Law LLP.
While the maximum amounts of management fee are set by the PPP/concession agreement, the actual amounts can be reduced if the private partner is in violation of the agreement terms related to service quality.9
Availability payments can be included in the PPP/concession agreement as payable out of the state budget, where availability is to be specified as operational and qualitative characteristics as well as individual, technical, and economic parameters of the PPP/concession object.10 According to the Concessions Law, they can be the sum of ICC, OCC, and the management fee; while in the PPP Law, they are a sum of OCC and the management fee (ICC is a separate component). Availability payments can be combined with other means of state support payable from the state budget.11 However, unlike the Concessions Law, the PPP Law does not provide a requirement for the PPP project to be “socially important” to qualify for the availability payment.
Credit Enhancement Measures
The PPP Law contemplates various measures of state support aimed at enhancing the ability of the private partner to raise affordable long-term debt and encourage the participation of institutional investors. Among such measures are the following:
- state sureties for infrastructure bonds (not necessarily placed on the Kazakhstan stock exchange);
- state guarantees for loans, aimed at financing PPP projects;
- demand-related guarantees (e.g., offtakes by the state entities, shadow tolls); and
- rent fee for use of the object owned by the private partner.
The guarantees are applicable for the projects initiated by the government entity as well as those initiated by the private player under the direct negotiation model defined in the PPP Law, subject to the receipt of various approvals listed in the Budget Rules on the provision of government guarantees.12
Typically, a fee of 2% of the guarantee amount is charged from the private player seeking guarantees.
According to the PPP Law, the budget execution central authorized body shall
- enter into contracts of state guarantees and sureties under contracts of PPP,
- keep a register of state guarantees and sureties provided by the state under PPP agreements, and
- record the acceptance and fulfillment of the state’s financial obligations under a PPP agreement.
The Concessions Law also mentions the following credit enhancement instruments:
- state guarantees for infrastructure bonds under concession agreements,
- state guarantees for loans attracted to finance concession projects, and
- guaranteed offtake of a certain volume of goods (works, services) by the state.
Sources: ADB. 2019. Public–Private Partnership Monitor. Second Edition. Manila. https://www.adb.org/sites/default/files/ publication/509426/ppp-monitor-second-edition.pdf; Unicase Law LLP.
Project Development Funding
Project Development Funding What are the various sources of funds for PPP project preparation? Budgetary allocations
Dedicated project preparation/project development fund
Technical assistance from multilateral/bilateral/and donor agencies
Recovery of project preparation funding from the preferred bidder
At what stage of the PPP project, can the project preparation/development funding be availed by the government agency? Pre-feasibility stage
Detailed feasibility stage
Transaction stage
Is there a list of project preparation/project development activities towards which the project development funding can be utilized? Can the project development funding be utilized to appoint transaction advisors for PPP projects? Is there a specific process to be followed by government agencies to appoint transaction advisors? What are the payment mechanisms for making payments to transaction advisors? Timesheet-based
Milestone-based
Are there standard agreements and documents to avail project development funding? Who are the signatories to the project development funding agreements? Respective line ministry or akimat Is there a threshold size (investment) for a PPP project to avail project development funding? - Yes
- No
LEARN MOREGovernment Support for PPP Projects
The function of project preparation for PPP projects is scattered among many entities both at the republican and regional levels. At the republican level, the most prominent entities are Turar Healthcare under the Ministry of Healthcare (MOH), JSC Financial Center under the Ministry of Education (MinEdu), and KazCenter ZhKH under the Ministry for Industry and Infrastructure Development (MIID), a national operator for state programs in housing and utilities. At the regional level, each akimat has established its own PPP center whose functions sometimes overlap with project preparation and approval. The financing of project preparation (if initiated by the public entity) is mostly provided from the state budget (republican and/or regional) and quasi-state-owned enterprises. There is also significant support from international financial institutions (IFIs) (ADB, European Bank for Reconstruction and Development [EBRD], and the International Finance Corporation [IFC]) in providing technical assistance for project preparation. Where projects are initiated by the private entity, the project preparation is financed by the prospective concessionaires themselves.
PPP Center
The joint stock company “Kazakhstan Center for Public–Private Partnership” (the PPP Center) was set up in 2008 in accordance with Government Resolution No. 693 dated 17 July 2008. Its sole shareholder is the Ministry of National Economy (via the Ministry of Finance’s State Assets and Privatization Committee). Its main purpose is the provision of expert opinions and advisory to the government. It mainly provides support during tenders, assists with the coordination of project monitoring, keeps the PPP project register, and renders methodological advice and training to regional PPP centers.
The PPP Center is financed out of the republican budget via the payments for provision of expert opinions on projects, training, and project marketing activities.
Turar Healthcare and Financial Center
JSC Turar Healthcare has been established in 2020 with the aim to address healthcare infrastructure gap and attract investments in the sector. It acts as the national healthcare sector operator under the MOH, with government being its sole stakeholder. Turar Healthcare’s main role with regard to PPP is to attract investors, act as the medical operator in facility management PPPs, and provide advisory support for health-care projects during project structuring.1
JSC Financial Center is the national operator for PPP allowing educational facilities to build or reconstruct student dormitories with the assistance from developers, construction firms and provides financing for private schools and dormitories on a per-capita basis. The government, via the MinEdu, guarantees the reimbursement of the developers’ investments. As an operator for this program, the Financial Center is also responsible for the provision of standards, calculations, and assistance in contracting. It is also a party to PPP agreements.2
Regional PPP Centers and Social Entrepreneurial Corporations
Regional governments have been strongly encouraged to use PPPs to deliver infrastructure and public services. The regional PPP centers have emerged from social-entrepreneurial corporations (SECs), which had been created in each regional/republican city in 2006, to promote regional economic development through social corporate responsibility. Initially, the SECs have been responsible for promoting PPPs in their respective regions. In 2013, the government created a PPP Coordination Council which instructed all akimats to set up regional PPP centers to take over the function of promoting PPP from the SECs.
There are currently 16 regional entities involved in PPP, fully owned by their respective akimats. These centers are mostly developing small-scale PPPs in social infrastructure and urban utilities. They provide services for preparation, assessment, and ex-post evaluation of PPP projects to their respective regional governments. They are funded by the regional governments themselves, while project preparation costs can be recovered out of the winning bids.
International Financial Institutions
The three most active players supporting PPP among the IFIs are ADB, EBRD, and IFC. Each have PPP as a priority in their country programs and operational strategies, supporting a pipeline of PPP projects, such as in health care, transport, urban infrastructure, and water supply.
International Financial Institutions’ Support to PPP Project Preparation
Project Project Cost, Status Supporting IFI Comment BAKAD $585 million, closed IFC – as lead financial and technical consultant.
EBRD – provided grant for legal advisor.It took 11 years for project preparation, tendering, and reaching financial close. Almaty LRT $270 million–$320 million, tender announced EBRD – provided grants for feasibility study, financial consultant, and legal consultant (between 2009 and 2018).
UNDP – provided grant for technical and financial consultant (2016–2018).The project was structured as a regional PPP according to the PPP Law. The RFQ was announced in 2018 and attracted the attention of reputable international bidders. The Akimat of Almaty City has not yet announced the second stage. Asfendiyarov Hospital $100 million–$120 million, under approval EBRD – provided grant for financial, technical, and legal consultant. The project is structured as a republican facility-management PPP in accordance with the provisions of the PPP Law. The grantor is the MOH and the primary service provider is the Almaty Medical University. BAKAD = Big Almaty Ring Road, EBRD = European Bank for Reconstruction and Development, IFC = International Finance Corporation, LRT = light rail transit, MOH = Ministry of Healthcare, RFQ = request for qualification, UNDP = United Nations Development Programme.
Source: Unicase Law LLP.
This table depicts a pipeline of selected projects supported by the IFIs.
Maturity of the PPP Market
PPP Project Statistics Is there a national PPP database for the country?
Is the distribution of PPP projects across infrastructure sectors available? Is the distribution of PPP projects across various stages of the PPP life cycle available? - Yes
LEARN MOREMaturity of the PPP Market
The Kazakhstan PPP Center regularly updates the PPP Project Database in their website. The database provides a list of projects that are undertaken on PPP.
PPP Projects Database
Description Units Total number of projects 1,362 At the bidding stage 62 Signed contracts 1,054 Terminated contracts 72 Total amount of attracted and planned investments $2,289 million Source: Government of Kazakhstan, Kazakhstan Public–Private Partnership Center. PPP Project Database. https://kzppp.kz/projects (accessed 18 October 2022).
In this table, the latest statistics from the database, updated by the PPP Center on 1 September 2022, are reflected.
The project database provides various details such as the contracting agency, project type, stage of development, estimated cost, final cost, sector, dates, project capacity, form of PPP, and name of the private player.
The database is also collated and maintained at different levels. For example, the PPP Law states that
- the local executive bodies shall keep a register of concluded PPP agreements on local PPP projects, and
- access to the register is provided by the state assets record keeper to the authorized representatives of state bodies.
The World Bank PPP Reference guide defines PPP as “a long-term contract between a private party and a government entity, for providing a public asset or service, in which the private party bears significant risk and management responsibility, and remuneration is linked to performance.”1
The PPP Law, however, provides a different definition as mentioned above (PPP Law, Article 4):2
- conclusion of PPP agreement,
- mid- or long-term project life (from 5 to 30 years),
- joint participation of the grantor and the private partner in the PPP project,
- combination of resources of the grantor and the private partner to develop the PPP project, or
- investments from the private partner side.
Consequently, quite a few of the projects listed in the database are too short in duration (5 years), and do not involve risk transfer (mostly regional primary education PPPs), and management responsibility and remuneration may not be linked to performance.
This is the main reason behind the vast discrepancies in the number of PPP projects among the various databases (e.g., 24 in the PPP Legal Resource Center3 versus 1,362 in Kazakhstan’s PPP Center database).
- 1PPP Legal Resource Center. What is a PPP: Defining “Public–Private Partnership.” https://ppp.worldbank.org/public-private-partnership/what-ppp-defining-public-private-partnership
- 2The Concessions Law does not contain an explicit description of concession distinctive features.
- 3PPP Legal Resource Center. Country Profile: Kazakhstan. https://ppp.worldbank.org/public-private-partnership/country-profile-kazakhstan.
Sources: ADB. 2019. Public–Private Partnership Monitor. Second Edition. Manila. https://www.adb.org/sites/default/files/ publication/509426/ppp-monitor-second-edition.pdf; Unicase Law LLP.
PPP Project Pipeline
Does the country publish a national PPP project pipeline? At what frequency is the national PPP project pipeline published? Is the national PPP project pipeline based on the national infrastructure plan for the country? - Yes
- Unavailable
LEARN MOREMaturity of the PPP Market
The republican PPP project pipeline is published from time to time as a government order issued by the Ministry of National Economy. Before approval, the regional pipelines are published by the regional maslikhats (local representative bodies).
PPP Book
Sources of PPP Financing Who are the typical entities financing PPP projects in the country? Private developers
Construction contractors
Institutional/financial/private equity investors
Pension funds
Insurance companies
Banks
Nonbanking financial corporations/Financial institutions
Donor agencies
Government agencies and state-owned enterprises
What is the distribution of financing among these entities financing PPP projects? Does the country have the history/track record of issuing bonds by infrastructure projects? How many infrastructure projects private developers for infrastructure projects have raised funding through bond issuances? 2 What is the value of funding raised through capital markets by PPPs? Does the country have a matured derivatives market to hedge certain risks associated with PPPs? Does the country have a national development bank? Does the country have credit rating agencies to rate infrastructure projects? Typically, what are the credit ratings achieved/received by infrastructure projects? Is there a threshold credit rating for infrastructure PPPs below which institutional investors, pension funds, and insurance companies would not invest in infrastructure PPPs? What is the typical funding model for infrastructure PPPs -- corporate finance or project finance? Are there regulatory limits/restrictions for the maximum exposure that can be taken by banks to infrastructure projects? - Yes
- No
- Unavailable
LEARN MOREMaturity of the PPP Market
Typical Contours of Infrastructure Financing
Non/Limited Recourse Loan Non/Limited Recourse Local Currency Loan Project Financing, Local Public Sector Banks Interest Rate Swaps Currency Swaps Project Financing through Project Bond Issuance Maximum Tenor, in years 15 No data 15 years Only for hard currency loans (data unavailable) $ Forward duration of currency rate swap – 1 to 2 years for $ Up-front arrangement fee, bps Up to 100 bps Up to 100 bps Floor rate LIBOR KIBOR or current official inflation rate Margin rate, bps 150–800 bps 150–800 bps Political risk cover premium 10–50 bps Percentage of foreign debt out of total debt for project financing NA Percentage of project bonds out of total debt for project financing <30% Typical debt–to–equity ratio No data Timeline to financial close (month) 6–12 months Minimum DSCR covenant levels, x 1.1x–1.5x bps = basis points, DSCR = debt service cover ratio, KIBOR = Kazakhstan interbank offered rate, LIBOR = London inter-bank offered rate, NA = not applicable.
Source: Unicase Law LLP.
This table reflects the key parameters and contours of the infrastructure financing in Kazakhstan.
The principal sources of financing in Kazakhstan are as follows:
- Debt from multilateral development institutions. The key banks lending to the PPP projects on a limited recourse basis are ADB, EBRD, and the Islamic Development Bank (IsDB). The Eurasian Development Bank (EDB) and Development Bank of Kazakhstan (DBK) have recently joined the peers.
- Debt from state-owned institutions. Baiterek Holding and its affiliates offer a wide range of financing from equity to debt to guarantees.
- Bond finance. PPP project entities can issue infrastructure tenge-denominated bonds, supported by government guarantees. Listing on Kazakhstan’s stock exchange might be attractive due to an exemption from withholding tax for listed bonds. Batys Transit, a PPP project on the construction of a high-voltage transmission line in West Kazakhstan, issued such bonds in 2006.
- Local bank debt. Local commercial banks could not provide financing to PPP projects due to strict prudential requirements on loans secured by take-or-pay contracts and future receivables (provisions are up to 50% of exposure). The Agency for Regulation of Financial Markets of Kazakhstan has recently issued a regulation lifting this requirement, which should make local bank financing more available for future PPP projects.
The overwhelming majority of the more than 1,300 PPP projects signed in Kazakhstan to date and registered in the PPP Center’s database are small by amount (for instance, as small as T1,200, or approximately $28, for management of a school canteen in Jambyl Region) and short term in duration (e.g., 2 years for management of a stadium café in North Kazakhstan). The private parties in such PPP are predominantly individual entrepreneurs or SMEs with limited borrowing capacity, if any.
Against this trend, there have been four large-scale concession/PPP projects in the past 36 months, which have been sponsored and financed on a limited recourse basis. Two of them were based on unsolicited proposals; only BAKAD has been tendered out internationally.
Active Project Sponsors in 36 Months Preceding March 2021
Name of Sponsor (Project) Financing Raised ($ million) No. of Transactions Alsim Alarco, Türkiye (BAKAD) 585 1 Makyol, Türkiye (BAKAD) 585 1 SK Ecoplant, Republic of Korea (BAKAD) 585 1 Korea Expressway Corp (BAKAD) 585 1 YDA (Turkestan Airport) 277 1 ADFD, UAE (Turkestan Airport) 277 1 Kazakhtelecom, Kazakhstan (rural broadband internet) 546 1 Transtelecom, Kazakhstan (rural broadband internet) 546 1 Eurotransit, Kazakhstan (automobile border crossing point with the PRC) 205 1 ADFD = Abu Dhabi Fund for Development, BAKAD = Big Almaty Ring Road, PRC = People’s Republic of China, UAE = United Arab Emirates.
Source: Unicase Law LLP.
This table lists the sponsors of these four projects.
Active Lenders to PPP Projects in 36 Months Preceding March 2021
Name Debt Provided ($ million) No. of Transactions ADB (renewables)a >40 2 EBRD (BAKAD) 225 1 EBRD (renewables)a >200 11 EDB 315 3 Bank of China 100 1 IsDB 100 1 DBK 90 1 PGGM 25 1 ADB = Asian Development Bank, BAKAD = Big Almaty Ring Road, DBK = Development Bank of Kazakhstan, EBRD = European Bank for Reconstruction and Development, EDB = Eurasian Development Bank, IsDB = Islamic Development Bank, PGGM = Pensioenfonds Voor De Gezondheid Geestelijke en Maatschappelijke.
Note: The list of active lenders includes banks and nonbanking financial institutions.
a While renewable energy projects supported by state-sponsored power purchase agreements are not considered as PPP in Kazakhstan, most banks treat them as such.
Source: Unicase Law LLP.
This table shows the most active lenders during 2019–2021 for PPP projects in Kazakhstan.
Credit Rating Agencies in Kazakhstan
A new state body, the Agency for Regulation and Development of the Financial Market of the Republic of Kazakhstan, was formed based on the Decree No. 203 dated 11 November 2019 to further improve the “state administration system of the Republic of Kazakhstan.” The agency is a state body responsible for protecting the rights and legitimate interests of consumers of financial services. It also contributes to the stability of the financial system and the development of the financial market, carries out state regulation, controls the financial market, and supervises financial organizations and people within their competence.
The new state body provides information on credit bureaus operating in the country, which include JSC “The State Credit Bureau” and the “First Credit Bureau” LLP. They provide personal credit and corporate credit reports.
- First Credit Bureau LLP. The First Credit Bureau is one of the largest technology companies in Kazakhstan with the most up-to-date database of credit histories and more than 40 services in the field of providing data for credit and non-credit processes, statistics, and predictive analytics for the financial market. The first credit bureau is a leader in the field of credit analytics and scoring models used in different segments of the financial market.1
- The State Credit Bureau. The State Credit Bureau was established as a joint stock company by the Resolution of the Board of the National Bank of Kazakhstan “On approval of the joint-stock company,” State Credit Bureau No. 213 dated 4 July 2012. The State Credit Bureau is a specialized nonprofit organization whose main activities are the formation of credit histories and the provision of credit reports and credit scoring services.
There are local rating agencies in the country including Rating Agency of Regional Financial Center of Almaty, Expert RA Kazakhstan, and KZ-rating Agency. However, specific information related to full-fledged credit rating agencies operating in Kazakhstan is not available.
- 1First Credit Bureau. 2022.https://www.1cb.kz/about.
Sources: ADB. 2019. Public–Private Partnership Monitor. Second Edition. Manila. https://www.adb.org/sites/default/files/publication/509426/ppp-monitor-second-edition.pdf Unicase Law LLP.
